Water Project "WP Oct2022"

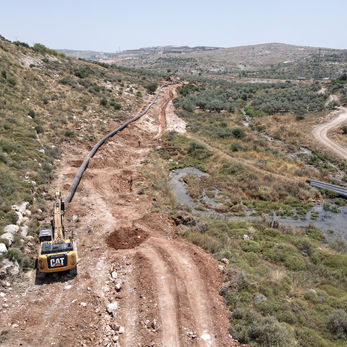

Commencing preparations for the water project along the roads, inclusive of laying a fiber communications line stretching from the Ariel area to Berkane in collaboration with the Makrut International Water Company. The main water pipeline boasts a diameter of 30 inches and spans a length of 7,100 meters. Additionally, the excavation residues are meticulously reprocessed through grinding and re-silting procedures. Utilizing advanced technology, the pipeline is inspected with a robotic device navigating inside the pipe for thorough examination. Emphasizing the utmost quality, the concrete maintenance department is engaged in repairing and reinforcing concrete structures at welding points, adhering strictly to specified standards. Comprehensive road safety measures are implemented throughout the project, particularly crucial given the challenging terrain. This multifaceted endeavor encompasses three pits stations.



Commencing drilling operations and preparing the pipes



Water Project "WP Apr2022"

Undertaking the water line project for Makrot Company along Street 55, extending from Al-Kana to the Barkan Industrial Zone, covering a distance of 10,600 meters with a diameter of 28 inches. The project entails drilling and insulating iron pipes, welding, and recycling drilling by-products in accordance with the provided design maps. Environmental preservation and tree protection are paramount, alongside ensuring public safety on roads and the smooth operation of distribution stations :

1- Distribution station "28 : installation valves of "28 , "24 , additional valves will be installed as necessary, outlined in image A1 :



2- Distribution station "30 : installation valves of "30 , "28 , additional valves will be installed as necessary, outlined in image A2:

Utilizing the resultant rocks, sorted by grinding size, for filling pipes and fortifying roads within the same project is a sustainable approach aimed at environmental conservation and safeguarding agricultural lands, as illustrated in the attached images :


The laying and welding of pipes as in the provided image

The olive trees situated along the project path will be carefully relocated to alternate locations, ensuring all necessary precautions are taken to preserve their health and vitality. This relocation process are overseen by agricultural engineers in coordination with the departments of agriculture and environment, guaranteeing the successful transplantation of the trees .


Executing the drilling operations will be carried out in two sections as outlined below:

1-Horizontal Excavator in North "HEN 1": Spanning a length of 65 meters with a diameter of 36 inches.
2-Horizontal Excavator in North "HEN 2": Covering a length of 45 meters with a diameter of 36 inches.

Public safety measures according to maps approved by the police and local authorities :

We express our gratitude to the dedicated crew for their tireless efforts in completing the project, ensuring the provision of essential water services.

Sewage Project "SW May2024"

The implementation of a sewage pressure line with a diameter of 800 mm has now begun from the Ariel area to the Kafr Qasem “Ofek Shomron” area, with a length of 9,500 meters

Starting  laying Politilien pipes 800 mm in sewage project :

 Laying pipes and clay from the same soil resulting from the drilling process :

Water Project "WP Oct2022

Commencing preparations for the water project along the roads, inclusive of laying a fiber communications line stretching from the Ariel area to Berkane in collaboration with the Makrut International Water Company. The main water pipeline boasts a diameter of 30 inches and spans a length of 7,100 meters. Additionally, the excavation residues are meticulously reprocessed through grinding and re-silting procedures. Utilizing advanced technology, the pipeline is inspected with a robotic device navigating inside the pipe for thorough examination. Emphasizing the utmost quality, the concrete maintenance department is engaged in repairing and reinforcing concrete structures at welding points, adhering strictly to specified standards. Comprehensive road safety measures are implemented throughout the project, particularly crucial given the challenging terrain. This multifaceted endeavor encompasses three pits stations .

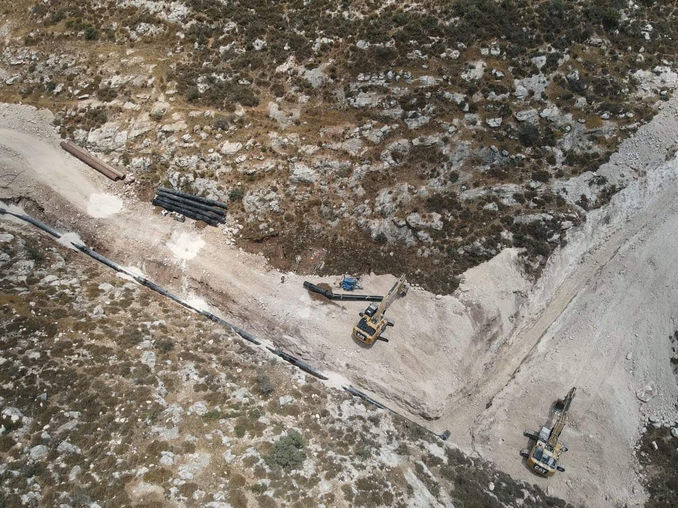

- Initially, the roads were cleared, and waste was promptly disposed of, as depicted in the image :

Commencing drilling operations and preparing the pipes

Initiating pipe laying and welding operations

As part of the necessary work aligning with land and road requirements, corners are constructed using plastic pipes, as illustrated in the pictures

Commencing slurry operations

This project encompasses three excavation sites, each with distinct specifications:

Executing the drilling operations will be carried out in three sections as outlined below:

1-Horizontal Excavator in North "HEN 1 : Spanning a length of 35 meters with a diameter of "40 .
2-Horizontal Excavator in North "HEN 2 : Covering a length of 65 meters with a diameter of "40 .

3-Horizontal Excavator in North "HEN 3 : Spanning a length of 120 meters with a diameter of "48 .

Initially Preparing the ground for the drilling machine involves meticulously pouring cement to create a stable foundation, ensuring optimal conditions for flawless execution of the task :

Showen the excavations pictures and videos :

Adorah Project 2022

 Dahdoor Group

Navooh Bridge 2022

 Dahdoor Group

Nabi Mosa Project 2022

 Dahdoor Group

Beit Hagai 2022

WhatsApp Image 2022-01-06 at 18.37.19 (4).jpeg

Water Project ( Kanaa Burkan ) WP Oct2022

WhatsApp Image 2024-05-16 at 11.42.40.jpeg

Ishtamo Project 2022

 Dahdoor Group

Elaad Project 2022

 Dahdoor Group

Borkan Canal 2022

WhatsApp Image 2022-05-19 at 6.45.25 PM (1).jpeg

 Haramsa 2022

WhatsApp Image 2021-12-19 at 10.22.34 PM (3).jpeg
